Vulcan climbs on a bright plume through a black night sky on its first flight.

Two new heavy rockets share one engine, and both were grounded in 2026

Blue Origin’s BE-4 powers its own New Glenn and United Launch Alliance’s Vulcan. Both entered service in 2024–2025; by mid-2026 neither could fly, for different reasons.

NASA/Isaac Watson

Drawn from 26 sources: NASA (7), Spaceflight Now (7), United Launch Alliance (2), SpaceNews (2) and 8 others. About 6 minutes. Checked November 9, 2026.

By November 9, 2026, the two newest heavy rockets in the United States had not flown for months. United Launch Alliance’s Vulcan last launched on February 12. Blue Origin’s New Glenn last launched on April 19, and on the evening of May 28 a New Glenn exploded on its pad during an engine test.3,11 The two rockets belong to competing companies, but they share a supplier: the first stage of each is powered by Blue Origin’s BE-4 engine, two on Vulcan and seven on New Glenn.1,12

Three national programs depend on these rockets. Vulcan and New Glenn are two of the three rockets the Space Force has chosen for its most demanding national-security launches through 2032. New Glenn is to carry Blue Origin’s Blue Moon landers for NASA. And NASA’s Moon rocket, the Space Launch System, is to use Vulcan’s upper stage.15,16,21,24

An American engine for both rockets

Vulcan replaced the Atlas V

Vulcan replaced ULA’s Atlas V, whose first stage was powered by a Russian-made engine, the RD-180.2 Vulcan flies with zero, two, four or six strap-on solid rocket boosters, depending on how heavy the payload is and where it is going.1

Two BE-4s on Vulcan’s core stage

Vulcan’s core stage instead uses a pair of BE-4 engines, which burn liquid methane and liquid oxygen and are manufactured by Blue Origin. Its Centaur V upper stage uses two RL10C engines, built by L3Harris, burning liquid hydrogen.1

New Glenn, Blue Origin’s own rocket

New Glenn is Blue Origin’s own heavy rocket, launched from Launch Complex 36 at Cape Canaveral. Its first stage is designed to land on a ship and fly again; its upper stage burns hydrogen in BE-3U engines.10,12

Seven BE-4s on New Glenn’s first stage

Seven BE-4s power New Glenn’s first stage, the same engine that sits under Vulcan’s core stage.1,12

Vulcan: certified in March 2025, paused in March 2026

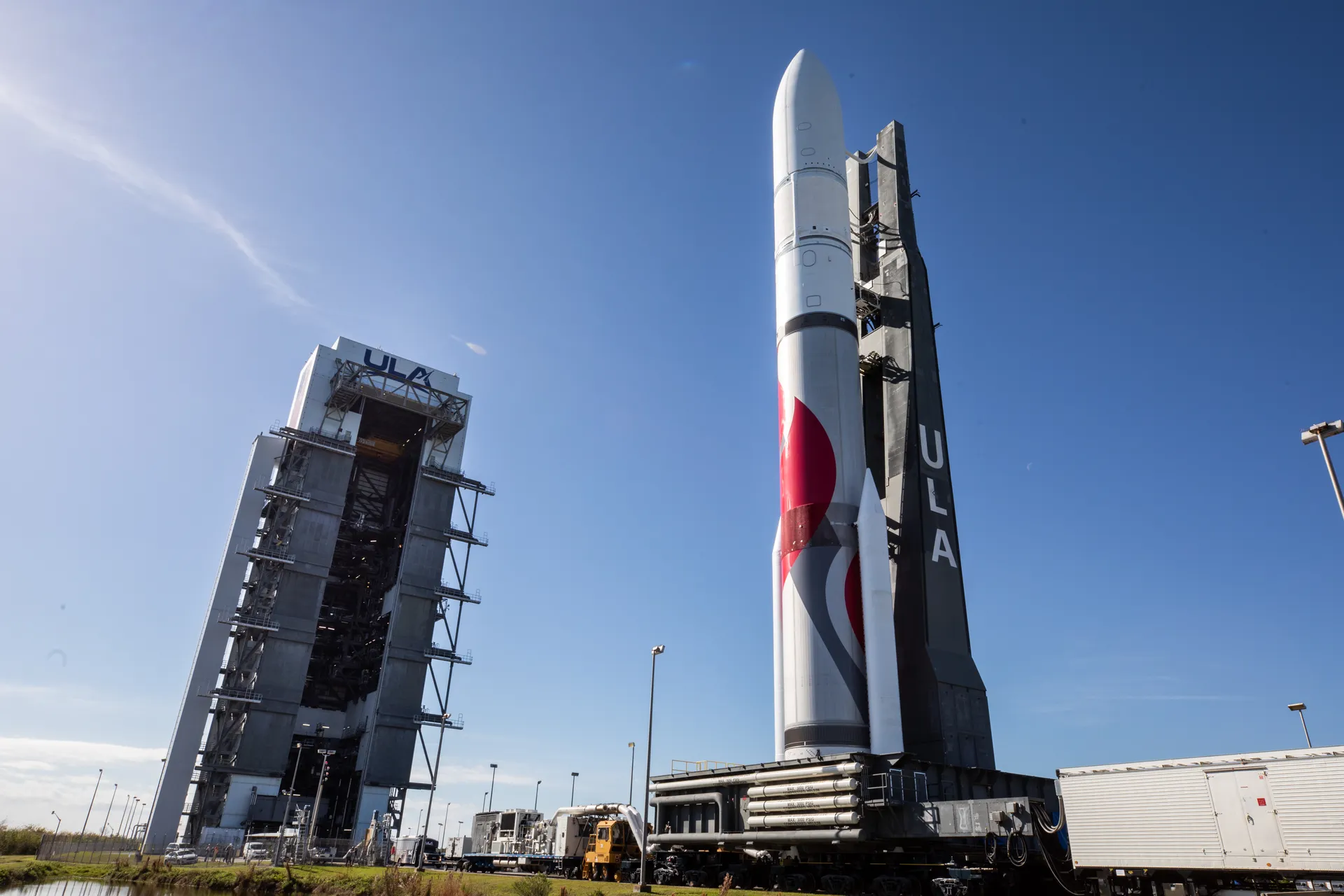

A white and red Vulcan rocket stands on its mobile platform beside the tall Vertical Integration Facility under a blue sky.
Vulcan rolls out to Space Launch Complex 41 with Astrobotic’s Peregrine lander, January 5, 2024.NASA/Cory S Huston

Vulcan’s first launch, at 2:18 a.m. on January 8, 2024, carried Astrobotic’s Peregrine lander, the first flight of NASA’s Commercial Lunar Payload Services initiative.4 Its second, in October 2024, reached orbit, but one of the Northrop Grumman GEM 63XL solid rocket boosters lost material from its nozzle. After analysis and hot-fire testing, the Space Force certified Vulcan for national-security launches in March 2025, and Vulcan flew its first such mission that August.3,5

On February 12, 2026, less than 30 seconds after Vulcan lifted off with the USSF-87 mission, one of its four boosters suffered what Spaceflight Now described as a possible burn-through of a nozzle. The rocket rolled noticeably as it pitched over, but the boosters separated normally and the Centaur delivered the payload. It was the second such booster problem in four Vulcan flights.5,8

By early March the Space Force had said it would stop flying national-security missions on Vulcan. “Until the anomaly is resolved, the U.S. Space Force will not launch national security space missions aboard the Vulcan launch vehicle,” said Col. Eric Zarybnisky. ULA had a backlog of about 25 Defense Department missions assigned to Vulcan, some already years late, and the Space Force could shift some of them to SpaceX, as it already had for some GPS launches.6 In April it was weighing whether Vulcan could fly lower-energy missions with no solid boosters at all while the investigation continued.7 Northrop Grumman test-fired a GEM 63XL on April 15, demonstrating nozzle design changes that were already in work, and ULA said it aimed to return Vulcan to flight by the end of the year.8,12 In late October it set the date: November 13, with 40 Amazon Leo satellites on the first Vulcan to carry six solid boosters; the launch is to use the improved nozzle design.22

NASA has its own reason to watch. ULA built the interim upper stage that sends Orion toward the Moon on SLS, then retired that production line to build Vulcan. With the more powerful Exploration Upper Stage canceled, NASA approved a sole-source approach in March 2026 to buy Vulcan’s Centaur V instead, for Artemis IV and V.21 GAO reported in July that the last interim stage would fly on Artemis IV, and in November NASA said it was pursuing both that stage and a stretched Centaur V for the flight; the SLS story follows the decision.16,24 According to NASA officials, fitting the Centaur V will take relatively minor changes, such as moving a propellant umbilical line a few feet down the launch tower.16

New Glenn: a Mars launch, then a reflown booster

A tall rocket rises on a bright orange flame at night between two lightning towers, clouds of exhaust lit white and green around the pad.
The first New Glenn lifts off from Launch Complex 36 at Cape Canaveral, January 16, 2025.U.S. Space Force/Senior Airman Samuel Becker

New Glenn reached orbit on its first flight, in January 2025. Its second, on November 13, 2025, launched NASA’s ESCAPADE mission: two small spacecraft built by Rocket Lab that are to orbit Mars and study how the solar wind strips away its atmosphere. NASA’s Launch Services Program bought that launch under its Venture-class Acquisition of Dedicated and Rideshare contract. The acting NASA administrator, Sean Duffy, tied the flight to the Moon program: “Every launch of New Glenn provides data that will be essential when we launch MK-1 through Artemis.”9

On April 19, 2026, New Glenn flew a first stage for the second time; it had flown on the ESCAPADE launch, and Blue Origin had replaced all seven of its engines. The booster landed on its ship again. But the upper stage suffered a thrust problem, which the FAA later traced to a cryogenic leak that froze a hydraulic line,11 and Blue Origin said the AST SpaceMobile satellite it carried had been placed “into an off-nominal orbit.”10

NASA’s plans run through the rocket. Blue Moon, the lander Blue Origin is building for NASA under a $3.4 billion contract awarded in May 2023, is to launch on New Glenn from Cape Canaveral, and like SpaceX’s lander it depends on refueling in low Earth orbit.18,19 For the 2027 Artemis III test in Earth orbit, Blue Origin’s lander test article is to launch first and wait in orbit for up to 30 days for Orion and its crew.17

An explosion on Launch Complex 36

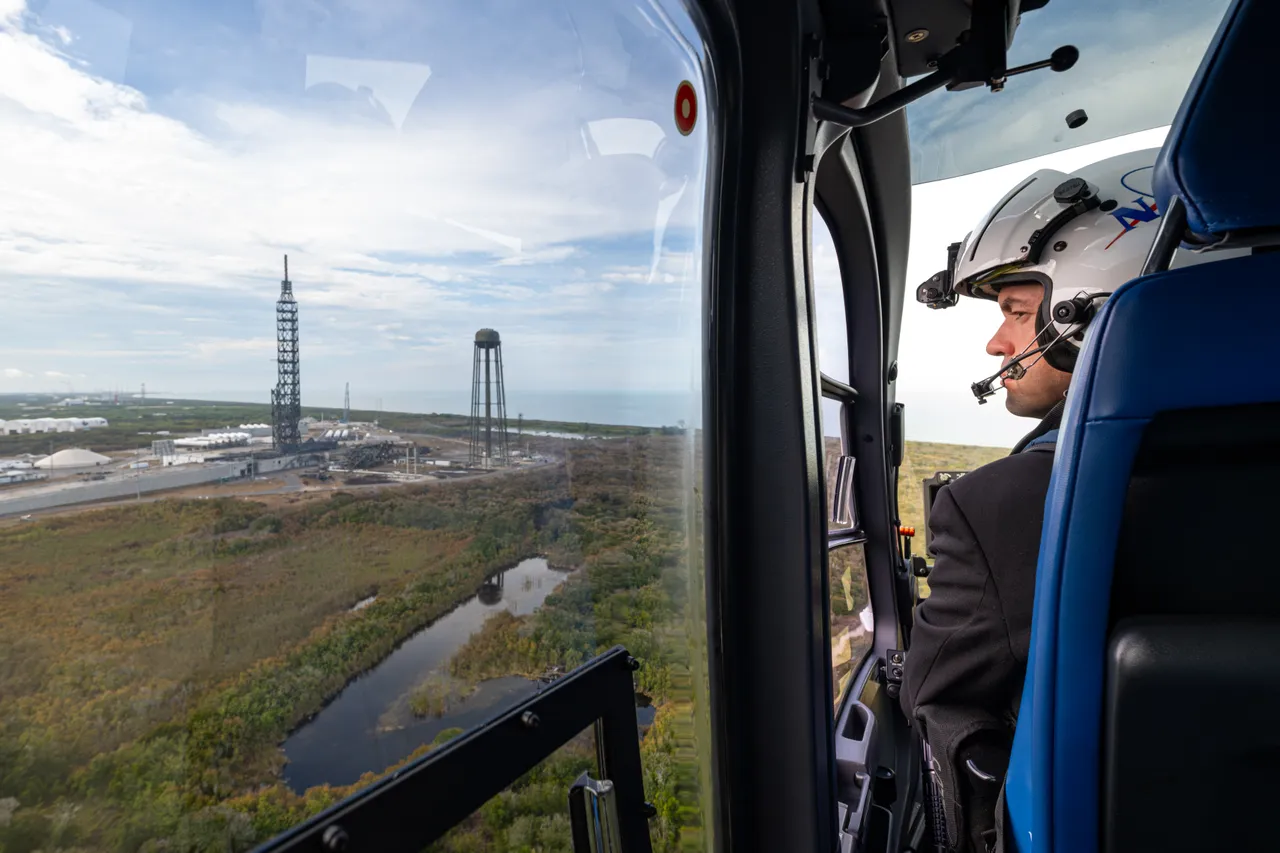

Through a helicopter window, the tall launch tower and the water tower of Launch Complex 36 stand over scrubland on the coast; NASA’s administrator looks out toward them from his seat.
Launch Complex 36 on May 29, 2026, the day after the New Glenn explosion, seen from the helicopter in which NASA Administrator Jared Isaacman surveyed the pad.NASA/John Kraus

At 9 p.m. on May 28, 2026, a New Glenn exploded during a static-fire test on Launch Complex 36, the engine firing that precedes a launch. It was being prepared to launch Amazon Leo internet satellites on June 4, the first of 24 New Glenn launches Amazon had bought; the satellites had not yet been brought to the pad. No one was hurt. The explosion appeared to destroy at least one lightning-protection tower and the transporter-erector that raises the rocket. Jeff Bezos, Blue Origin’s founder, wrote: “Very rough day, but we’ll rebuild whatever needs rebuilding and get back to flying.”11 NASA’s administrator flew over the pad the next day.13

In August Blue Origin traced the explosion to the main oxygen valve on one of the seven BE-4s. “We’re making small modifications to the valve that can be quickly retrofitted to existing engines,” said its chief executive, Dave Limp. Because Vulcan uses the same engine, ULA said Blue Origin would modify its BE-4s too, at ULA’s factory in Decatur, Alabama, and at Cape Canaveral. Blue Origin is rebuilding the pad around a new way of assembling the rocket and aimed to fly New Glenn again before the end of 2026.12,16 On November 4 Limp told employees that the return to flight had moved to January 2027: “This small adjustment doesn’t diminish what we’ve accomplished or the importance of the work still ahead.”23

Fifty-four national-security launches split three ways

On April 4, 2025, the Space Force awarded the second lane of its third National Security Space Launch competition: about $13.7 billion for an expected 54 launches to be ordered over five years and flown from fiscal 2027 to 2032. SpaceX was to receive 28, ULA 19 and Blue Origin 7. Lane 2 is for the heaviest and most critical payloads; providers must be able to launch from both the East and West coasts, place satellites directly into geosynchronous orbit and support vertical integration of payloads. Blue Origin had flown New Glenn once when the award was made.15

When each rocket would fly again22

202620272028NowVulcanSaid May 2026December 2026 — ULA: by the end of the yearSaid Oct 2026November 2026 — set for November 13New GlennSaid Aug 2026December 2026 — after the valve was foundSaid Nov 2026January 2027 — Limp’s memo, November 4

202620272028

Vulcan

  1. Said May 2026December 2026 — ULA: by the end of the year
  2. Said Oct 2026November 2026 — set for November 13

New Glenn

  1. Said Aug 2026December 2026 — after the valve was found
  2. Said Nov 2026January 2027 — Limp’s memo, November 4
Return-to-flight targets as ULA and Blue Origin stated them: Spaceflight Now, May 14 and October 28, 2026 (Vulcan); Spaceflight Now, August 6, and CNBC, November 5, 2026 (New Glenn).

Since early March 2026 the only one of the three able to fly those missions has been SpaceX’s Falcon 9. The BE-4s on the other two rockets are getting the same valve fix. In mid-September a Space Force acquisition official said the Space Force would review Vulcan’s return flight, the Amazon Leo mission, before clearing it for national-security launches again.6,8,12,20 In the meantime some of those launches were moved to SpaceX.26 New Glenn, which has flown three times, is to follow in January.3,23
