Artemis: how NASA’s plan to land on the Moon was built and rebuilt

A rocket, a capsule, two commercial landers, new suits and propellant refilled in orbit: who builds each piece, what it costs, and how a 2024 landing became Artemis IV in 2028.

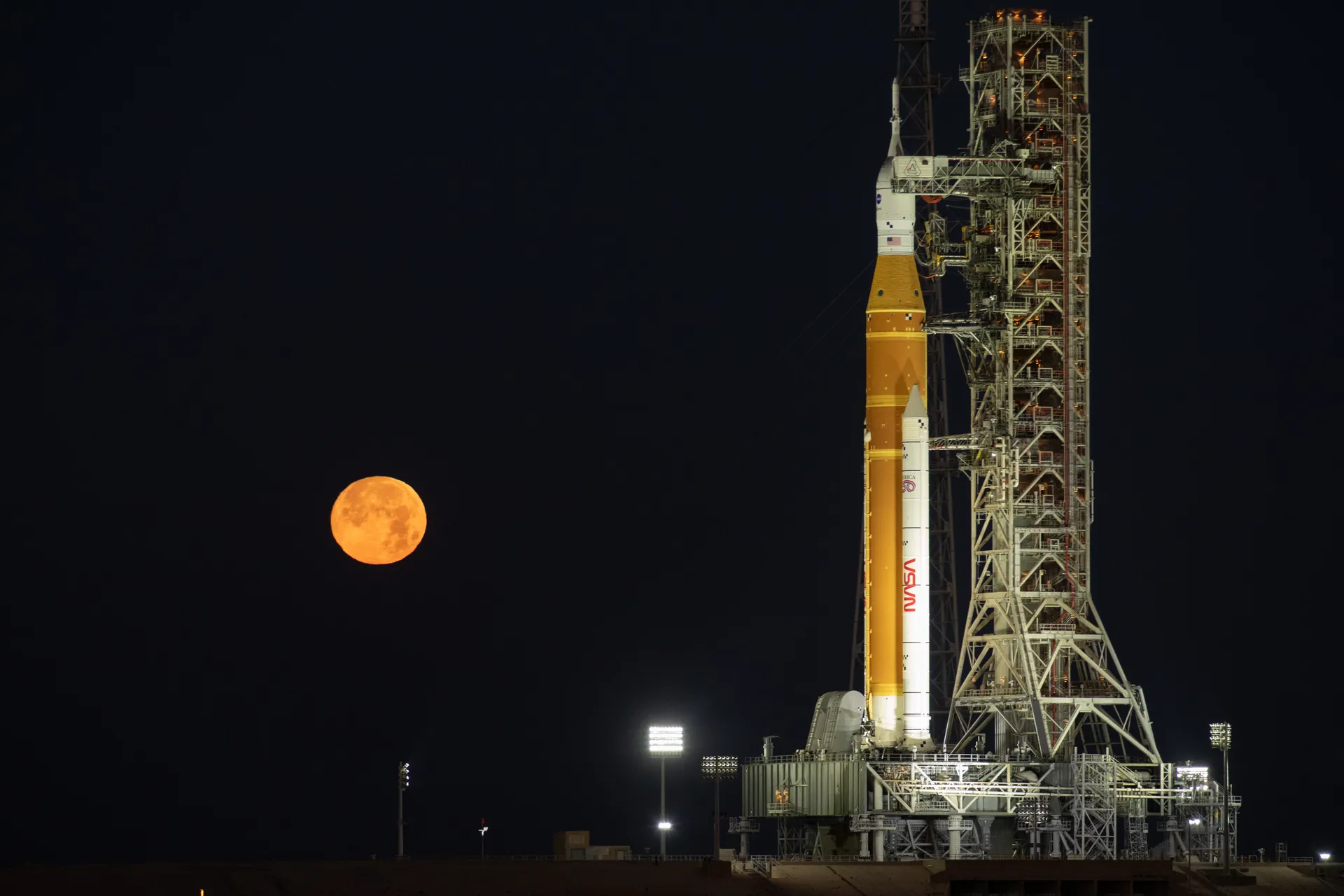

The full Moon, orange and low in a black sky, rises to the left of the Artemis II SLS rocket and Orion spacecraft standing beside their launch tower at night.
NASA/Ben Smegelsky

Drawn from 37 sources: NASA (27), NASA Office of Inspector General (3), Spaceflight Now, U.S. Government Accountability Office and 5 others. About 11 minutes. Checked November 9, 2026.

Artemis is NASA’s program to return American astronauts to the Moon and, this time, to stay. Its first crewed flight, Artemis II, carried four astronauts around the Moon in April 2026, farther from Earth than any humans had traveled before, and brought them home to a splashdown off San Diego.27 A landing asks for much more than that flight showed. It needs the SLS rocket and the Orion spacecraft, a commercial lander, the propellant or extra stages that carry that lander to the Moon, a spacesuit for the surface, and the launch and flight teams to bring all of them to the same place at the same time.9,17,30

As of November 9, 2026, the sequence is the one NASA laid out in February and March 2026. Artemis III, in 2027, will test rendezvous and docking with test versions of both commercial landers in low Earth orbit. The first landing moves to Artemis IV in 2028, and Artemis V is to follow by late 2028.10,11,32 On September 20, Administrator Jared Isaacman told NASA employees the agency was “~90 days broken against the Artemis III schedule,” with a best case of launching it in the summer of 2027 and preserving “as many as two opportunities for lunar landings in 2028.”25 On October 23 he and other agency leaders described how the landers would be sped up for 2028. Neither SpaceX nor Blue Origin has yet been assigned a landing; NASA will choose which goes first by the readiness of its lander, and a second crewed landing opportunity is to follow.30,31

A south pole landing ordered for 2024

Vice President Mike Pence speaks at a lectern with an Apollo command module behind him on the left and rocket models on the right; an audience fills the foreground.
March 26, 2019: Vice President Mike Pence at the National Space Council meeting in Huntsville, Alabama, where he called for a landing by 2024.NASA/Fred Deaton

On March 26, 2019, at the fifth meeting of the National Space Council in Huntsville, Alabama, Vice President Mike Pence said NASA should put American astronauts back on the Moon within five years. NASA Administrator Jim Bridenstine listed what that meant: land on the Moon’s South Pole by 2024, stay on schedule for flying the first SLS and Orion the next year, and send the first crewed mission to the lunar vicinity by 2022.1 NASA’s own schedule had aimed at 2028.2

NASA named the program Artemis, after the twin sister of Apollo, and in September 2020 published its plan. It had two parts: a near-term focus on achieving the initial human landing by 2024 as efficiently as possible with acceptable technical risk, and the build-up of sustainable systems that would keep a human presence on the Moon into the next decade. The landing would cost nearly $28 billion between fiscal years 2021 and 2025, NASA estimated.2

NASA’s Inspector General found in November 2021 that the $28 billion left out everything not directly needed for the first three missions, including the more powerful SLS Block 1B, the Mobile Launcher 2 that would launch it, future Orion capsules and the Gateway. Counted in full, the agency was projected to spend $93 billion on Artemis from fiscal year 2012 through 2025. The Inspector General also put the cost to build and fly a single SLS and Orion at $4.1 billion per launch for Artemis I through IV, not counting the money already spent developing them.3

The machines a landing needs, and who builds them

On a landing mission, a crew of four launches in Orion on SLS from Kennedy Space Center. Orion and the lander were to meet in the near-rectilinear halo orbit around the Moon; under the plan NASA described in October 2026, they will meet in an orbit that differs for each lander. SpaceX’s Starship, refueled in Earth orbit, will wait for Orion there, dock with it and push the joined spacecraft to low lunar orbit. Blue Origin’s stack of lander and transfer stages will fly to an elliptical polar orbit around the Moon, where Orion docks with it. Either way, two crew members take the lander to the surface near the South Pole for several days, living in it, and return to Orion for the journey home.30,31,17,9

Two astronauts in white Axiom lunar spacesuits stand on the floor of NASA’s Neutral Buoyancy Laboratory pool beside a U.S. flag, with divers around them.

NASA · September 24, 2025

SLS: the rocket NASA owns

SLS is a super heavy-lift rocket producing 8.8 million pounds of thrust at liftoff. Boeing builds its core stage at NASA’s Michoud Assembly Facility in New Orleans. All four RS-25 engines on Artemis III flew on space shuttle missions.18,23

An upper stage replaced in 2026

In February 2026 NASA froze SLS close to its first configuration. It stopped work on the Exploration Upper Stage and Mobile Launcher 2. For Artemis IV NASA is pursuing two upper stages, the interim cryogenic propulsion stage it already flies and a stretched version of United Launch Alliance’s Centaur V, so that it does not depend on either one.11,21,31

Orion: an American capsule on a European service module

Lockheed Martin builds Orion’s crew module, where four astronauts live and work. ESA, the European Space Agency, provides the service module that powers and propels it. Orion is the only spacecraft able to return a crew to Earth at lunar reentry speeds. Its docking system, for meeting a lander, flies for the first time on Artemis III.18,17,19

Starship HLS: a lander filled in orbit

In April 2021 NASA chose SpaceX’s Starship as the first lander, under a $2.89 billion fixed-price contract. Before a landing, SpaceX plans to launch a storage depot to low Earth orbit, then more than 10 tanker flights, one every six days. The filled lander waits for Orion in Earth orbit and, once they dock, carries both to the Moon.5,9,30

Blue Moon: a second lander

In May 2023 NASA selected Blue Origin as a second lander provider, at $3.4 billion. Blue Moon stands 52 feet tall and launches on Blue Origin’s New Glenn.6,9 In October 2026 Blue Origin chose to defer refueling in orbit: three transfer stages, launched to low Earth orbit ahead of the Mark 2 lander, will push it toward the Moon, each separating as its propellant runs out.30

Spacesuits, rented rather than owned

NASA will buy spacewalks as a service, renting suits from their maker; since Collins Aerospace’s work was descoped in 2024, that is Axiom Space. Axiom plans demonstration readiness in late 2027; the Inspector General warned that at historical testing rates, demonstrations would not come until 2031.16 In October NASA said it would also develop with Axiom a lighter suit for the first moonwalks, the Sortie.31

Who pays, and how: rockets NASA owns, landers it rents

By NASA’s 2026 count, the agency and its partners have invested more than $100 billion over nearly 20 years in crew-rated lunar transportation.12 NASA buys these machines in two different ways. SLS and Orion follow the agency’s traditional model: NASA owns the hardware it pays contractors to build. The landers are services. SpaceX and Blue Origin design, build and own them, and NASA purchases transportation under firm-fixed-price contracts with milestone payments, so a provider is paid only after NASA determines it has achieved a milestone defined in the contract. Under cost-plus contracts, the Inspector General notes, schedule delays typically raise costs because NASA keeps paying the provider’s labor.9

The difference shows in the overruns. Since the lander program began in 2019, NASA has obligated $6.9 billion for it and expects to spend $18.3 billion through fiscal year 2030. As of December 2025, SpaceX’s potential contract value had grown by 6%, about $253 million, and Blue Origin’s by less than 1%, or $13 million. When SpaceX asked for more time in 2023, NASA agreed in exchange for an added test: lifting off from the lunar surface on the uncrewed demonstration flight.9

Orion, built on the older model, accounts for most of the overruns among NASA’s major projects: in its July 2026 review, GAO found that Orion accounted for more than half of the year’s cost overruns and almost 75% of the cumulative overruns; Orion’s own came to about $3.5 billion. GAO also noted that NASA has still not produced a life-cycle cost estimate for the first Artemis landing mission, which GAO recommended in December 2019.21

How a 2024 landing slipped to 2028

The 2024 date lasted until the new administration’s first Artemis update. On November 9, 2021, Administrator Bill Nelson said that “with the recent lawsuit and other factors, the first human landing under Artemis is likely no earlier than 2025.” He listed first-time development challenges, an almost seven-month delay caused by Blue Origin’s lawsuit over the lander award, Congress not appropriating enough money for a lander competition, the COVID-19 pandemic, and a 2024 goal that was not technically feasible.4,9

The first crewed landing, as each new plan dated it

201920202021202220232024202520262027202820292030NowFirst crewed landingSaid Mar 20192024Said Nov 20212025 — at the earliestSaid Jan 2024Sept. 2026Said Dec 2024Mid-2027Said Jul 2025Early 2028Said Feb 20262028 — now Artemis IV

201920252030

First crewed landing

  1. Said Mar 20192024
  2. Said Nov 20212025 — at the earliest
  3. Said Jan 2024Sept. 2026
  4. Said Dec 2024Mid-2027
  5. Said Jul 2025Early 2028
  6. Said Feb 20262028 — now Artemis IV
Each line starts when a plan was announced and ends at the date it promised; dots mark the year named. Sources: NASA statements of March 2019, November 2021, January 2024, December 2024 and February 2026; NASA Inspector General, March 2026.

On January 9, 2024, NASA moved Artemis II to September 2025 and the Artemis III landing to September 2026. Testing of Orion’s life support had uncovered a battery issue and a faulty circuitry component for air ventilation and temperature control; the investigation of the Artemis I heat shield was still open; and SpaceX and Axiom needed more time for the lander and the suits.7 On December 5, 2024, after the heat shield investigation closed, NASA set Artemis II for April 2026 and Artemis III for mid-2027.8

By then the lander set the pace. Under its contract, SpaceX’s delivery for Artemis III had already moved from June 2025 to September 2026, and in the fall of 2025 SpaceX told NASA it would potentially not be able to meet a June 2027 launch date. In October 2025 NASA asked both SpaceX and Blue Origin for proposals to accelerate their landers for a landing in 2028.9 NASA says early 2028 had been its target landing date since mid-2025.11 Each slip brought the American date closer to China’s: in July 2023 the China Manned Space Agency set out a plan to land two astronauts on the Moon before 2030, launching a crewed spacecraft and a lander on two Long March 10 rockets to meet in lunar orbit. In 2024 the spacecraft was named Mengzhou and the lander Lanyue.34,35

February 2026: a rehearsal in Earth orbit before the first landing

On February 27, 2026, at a news conference at Kennedy Space Center, NASA announced it would standardize the configuration of its vehicles, add a mission in 2027, and undertake at least one surface landing every year thereafter. Artemis III, now in 2027, would test systems and operational capabilities in low Earth orbit to prepare for an Artemis IV landing in 2028: rendezvous and docking with one or both commercial landers, in-space tests of the docked vehicles, integrated checkout of life support, communications and propulsion, and tests of the new spacesuits.10

NASA described the change as an Apollo 9-style “test before you land” step. The old sequence had jumped directly from a lunar flyby to a lunar landing without testing Orion and a lander together in between, and launches had been trending toward one mission every three years.12,28

The entire sequence of Artemis flights needs to represent a step-by-step build-up of capability, with each step bringing us closer to our ability to perform the landing missions. Each step needs to be big enough to make progress, but not so big that we take unnecessary risk given previous learnings.
Amit Kshatriya, NASA Associate Administrator, February 27, 202610

On June 9 NASA named the Artemis III crew: commander Randy Bresnik, pilot Luca Parmitano of ESA, the first European assigned to an Artemis mission, and mission specialists Andre Douglas and Frank Rubio.19 The mission will launch three of the world’s most powerful rockets in short succession. Blue Origin’s test lander, built on the design of its Mark 2 crew lander, launches first into a circular orbit about 273 miles up and can wait there for up to 30 days. Orion launches on SLS only days later, docks with the Blue Moon test article and stays about two days while the crew open the hatch and assess its cabin, controls and life support. Later in the mission SpaceX launches a Starship Version 3 test article; the docking test with Orion is expected to last up to two hours, and astronauts will not enter the Starship. The planned 14-day mission ends with a splashdown in the Pacific off California.19,20,32

The Moon, photographed by the Artemis II crew with its South Pole at the top, shows a sunlit near side and part of the far side, with the dark rings of Orientale basin at the right edge.

March 2026: a base on the surface instead of a station in orbit

The Moon seen by the Artemis II crew on April 4, 2026, turned with the South Pole at the top: the region where NASA plans its first landings and its base.

NASA

On March 24, 2026, at an event NASA called Ignition, the agency described what would follow the landings. After Artemis V it will incorporate more commercially procured and reusable hardware, initially targeting crewed landings every six months. To achieve an enduring presence it will build a lunar base in phases, and it intends to pause Gateway, the small station that was to orbit the Moon, in its current form, shifting focus to infrastructure that enables sustained surface operations. Applicable Gateway equipment will be repurposed and international partner commitments used toward the base.13

The first phase is meant to replace bespoke, infrequent missions with a repeatable, modular approach. In March NASA counted 25 launches and 21 landings in it, “now through 2028”; by August it described the phase as running through 2029.13,29,24

The Moon Base in three phases, as NASA described them in 2026

  1. Through 2029

    Phase 1: repeatable deliveries24

    More than twenty robotic landings, which place science instruments, test new technologies and begin assembling habitation infrastructure before astronauts arrive.

  2. From 2029

    Phase 2: early infrastructure29

    Solar power stations, nuclear power demonstrations, Japan’s pressurized rover and about 60 metric tons of cargo.

  3. Early 2030s

    Phase 3: a semi-permanent crew presence29

    Fission surface power and habitats.

Isaacman put the base at about $20 billion over seven years.15 On November 7, 2026, NASA chose eight companies for CLPS 2, a 10-year contract for lunar deliveries with a combined maximum value of $10 billion.36

What has to be demonstrated before 2028

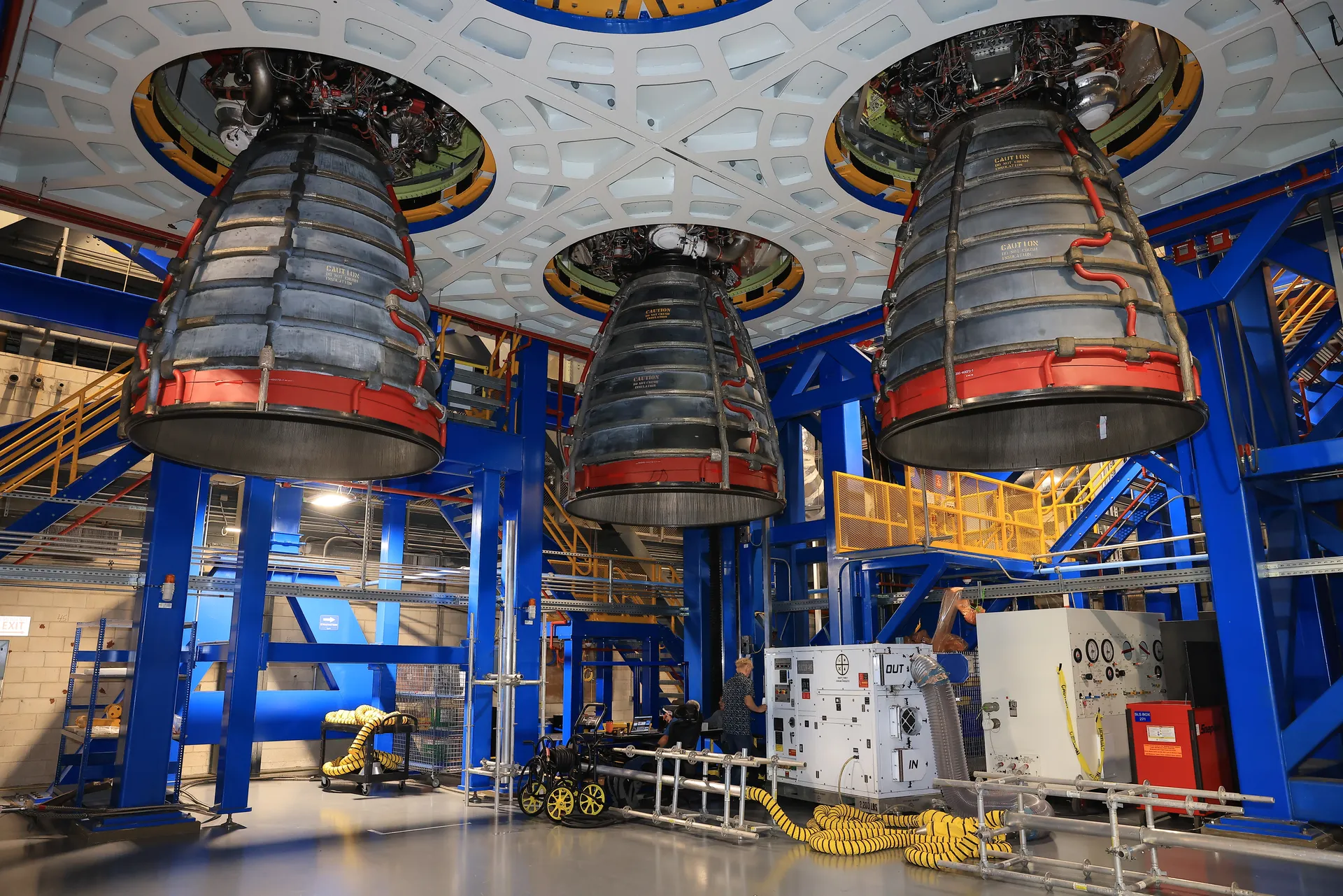

Three RS-25 engine bells hang from the base of the Artemis III core stage, seen from below inside the blue steel work platforms of the Vehicle Assembly Building.
August 28, 2026: three of the four RS-25 engines for Artemis III installed on the core stage in the Vehicle Assembly Building.NASA/Kim Shiflett

By the end of October 2026 the hardware for Artemis III was coming together at Kennedy. Orion’s crew and service modules were joined on July 30, technicians began installing the four RS-25 engines in the core stage on August 24, and in late October the core stage was set between the two solid rocket boosters on the mobile launcher in the Vehicle Assembly Building, ahead of a tanking test at Launch Pad 39B.22,23,33 The landers are further behind. Before any crewed landing, each provider must fly an uncrewed lunar landing test.21

SpaceX’s plan depends on moving cryogenic propellant from one Starship to another in orbit, which GAO and NASA’s lander program call a top risk; as of May 2026 it had not been demonstrated.21 On September 28, 2026, on its 14th flight, Starship reached orbit for the first time, deployed 26 Starlink satellites and returned after about two orbits. No transfer between ships was attempted, and as of November 9 Starship had not flown again.26,37 Blue Origin’s New Glenn, which must launch Blue Moon, exploded during a test at its launch pad in May 2026, and the company is rebuilding the pad with NASA’s help.21,25

The Inspector General added a limit that no schedule fixes. NASA is preventing hazards where it can, but should astronauts meet a life-threatening emergency in space or on the lunar surface, the agency does not have the capability to rescue a stranded crew.9 The 2028 landing now waits on a rehearsal in Earth orbit, an uncrewed landing by each lander that will carry a crew, a suit ready in time and, for a Starship landing, a transfer of propellant between ships in orbit.30,31 NASA’s lander program had scheduled the first transfer for 2026.21 Of the machines on that list, only SLS and Orion have flown with a crew, on Artemis II.
